A brand-new 500 kVA diesel generator rolled into a food processing plant outside the city last year — still smelling of export-crate timber, factory test certificate tucked into a plastic sleeve on the control panel door, the owner practically glowing. “Passed everything,” he told me, tapping the certificate. “Four hours at full load. Not a hiccup.”
He was right. And it didn’t matter. The factory test proves the generator worked in a factory. Commissioning day proves it works at your site — on your fuel, breathing your air, bolted to your concrete, pulling your loads. Same paint. Different machine. After a dozen years of commissioning work, I can tell you my ugliest surprises all arrived wearing a brand-new factory certificate.
Don’t get me wrong — a factory acceptance test is worth having. The set gets built, filled, wired, and run on a load bank while somebody with a clipboard watches every gauge. At Pavo the factory runs every set on a load bank before it ships, and I’m glad it does. It catches assembly mistakes while the crane and the spare parts are still in the same building.
But the factory is not your site. Your fuel isn’t their fuel. Your electrician’s exhaust routing isn’t the factory’s test cell. The shipping crate rode a truck, a crane, and quite possibly a monsoon. Commissioning — the site acceptance test — is where you check that the machine survived all of that and still does what the paper says. Skip it and you’re accepting a machine on the strength of a certificate, which is a bit like marrying someone on the strength of their wedding photos.
Here’s the thing most buyers get backwards: commissioning isn’t a formality before handover. It IS the handover. Everything you don’t test that day becomes your problem at 2 a.m. during the first real blackout, except by then the installer’s truck is long gone and the warranty argument has begun.
This is the mistake I find most often, and it scares me the most. A diesel generator protects itself with a handful of shutdowns — low oil pressure, high coolant temperature, overspeed, overcrank, emergency stop. Every buyer assumes they work. Almost nobody watches them actually trip.
Testing them takes an afternoon. The controller on any decent set has test modes or you can simulate the fault conditions — lift a sensor wire, use the controller’s built-in simulation, trip the E-stop and watch the fuel solenoid slam shut. You want to see the engine die on command. Not assume. See.
At a cold-storage warehouse job, we simulated low oil pressure during commissioning and the engine just… kept running. Smiling at us. 1,500 rpm of pure indifference. The shutdown circuit was wired, the sensor was fine, but a harness connector from the factory had never been fully seated. Found it on a Tuesday afternoon with coffee in hand. The alternative was finding it during a blackout with the engine eating itself alive. Which Tuesday would you prefer?
Overspeed deserves its own mention. The trip is usually set around 115% of rated speed, and it’s the last line of defense if the governor ever loses its mind. An old-timer I used to work with said testing shutdowns was paranoia — “a generator either starts or it doesn’t, kid.” He was wrong about a lot of things, but mostly he was wrong about this. Starting is the easy part. Stopping, on command, when something is going very wrong — that’s the part that saves engines.

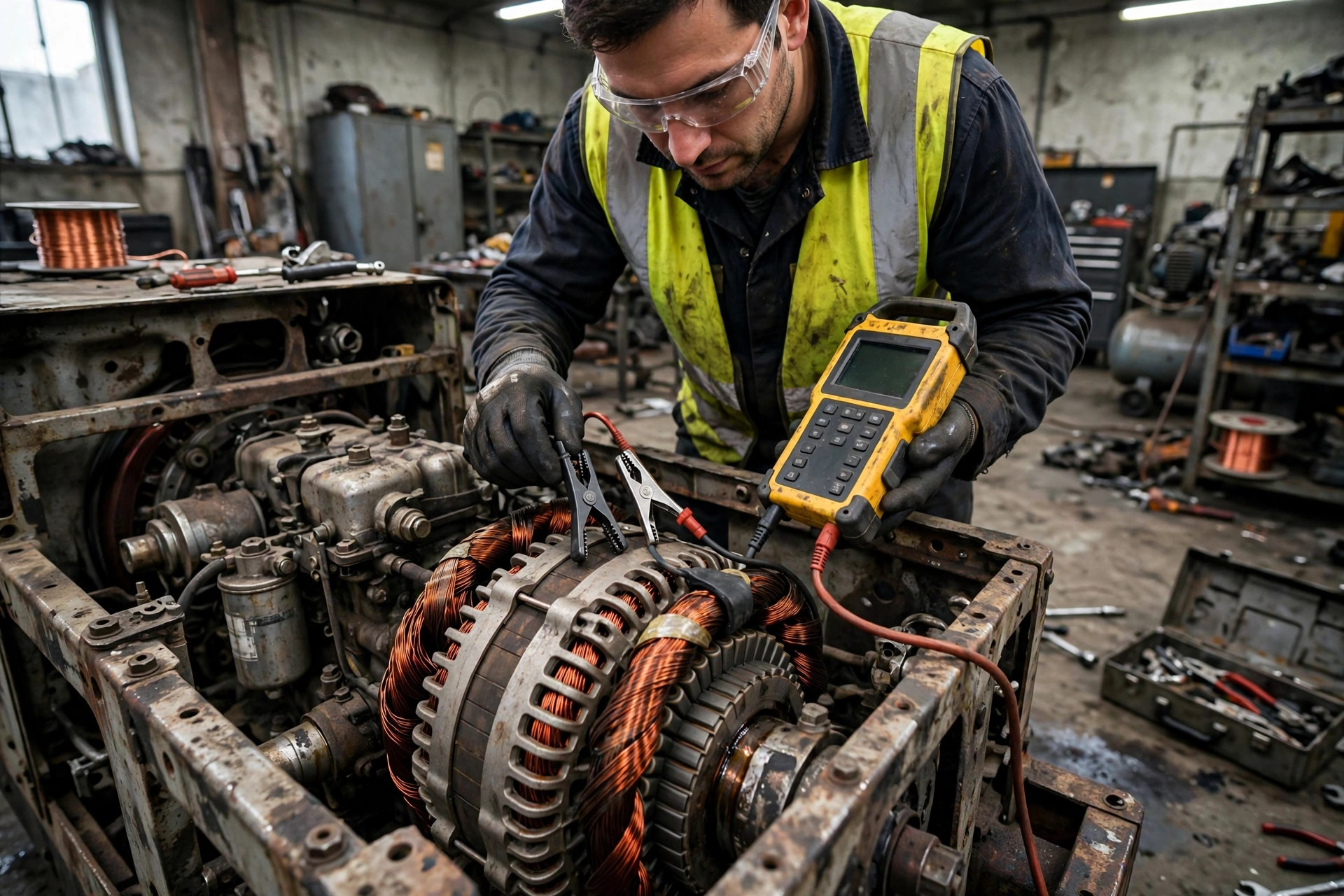

Before the first real start, somebody should put a megger — a 500-volt DC insulation tester — across the alternator windings and read the number. After weeks in a shipping container, possibly crossing an ocean, windings pick up moisture. Moisture plus high voltage equals a very short, very expensive light show.
What number do you want? In the field, most of us want to see comfortably into the megohms — single digits at a bare minimum, double digits ideally, measured with the windings near ambient temperature. Below that, you dry the windings first: space heaters, forced air, patience. Then you test again.
I once meggered a set that had crossed the sea during monsoon season. 0.8 megohms. The owner looked at me like I’d insulted his mother. We dried the windings for two days, re-tested at healthy double digits, and the set ran fine for years afterward. Had we just cranked it? Maybe fine. Maybe a winding flashover on day one, on a machine still under warranty, with everyone pointing at everyone else. The test takes twenty minutes. The argument takes months.
Honestly, this is the cheapest insurance in the whole commissioning process, and it’s the step that gets skipped most. Because the set is new. Because the crate was sealed. Because nothing looks wrong. Moisture doesn’t care how the crate looked.
The single most expensive sentence in this business is “it starts fine.” Starting proves the battery works and the fuel reaches the injectors. It proves almost nothing about whether the generator can do its actual job, which is carrying load — suddenly, fully, and without embarrassing itself.

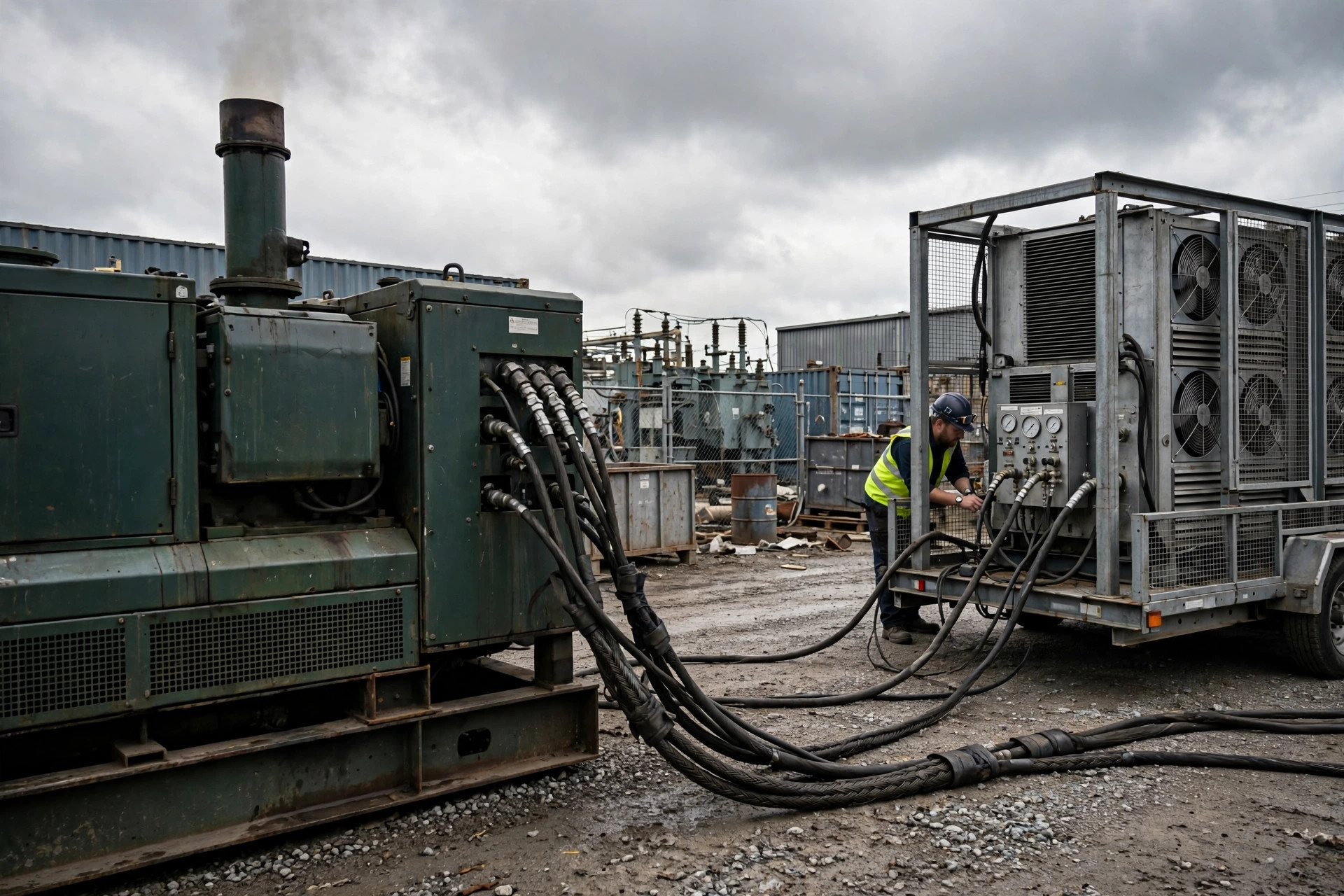

So load it. In steps, watching the meters like they owe you money. Voltage dip on a big step. Frequency recovery time. How the engine sounds when 60% of rated load slams on at once. The transient performance classes in ISO 8528-5 exist precisely because step loads are brutal — they’re the whole reason the standard bothers grading generators beyond steady-state numbers.
And here’s the ugly truth about step loading: it’s where installation mistakes surface. At a packaging plant, a 400 kVA set took small steps beautifully and fell apart past 80% load — coolant temperature climbing, engine audibly straining, controller flashing derate warnings. The factory test had been flawless. The difference? The site’s exhaust contractor had added three extra 90-degree elbows to route around a steel beam. Backpressure through the roof. We put a manometer on the exhaust during commissioning, proved it was over the engine maker’s limit, and the contractor re-routed the stack the following week. Our exhaust design piece explains exactly why elbows are the enemy — but the commissioning-day version is simpler: load the machine and let it complain. It will tell you what’s wrong. You just have to be there listening.
On life-safety jobs the stakes are codified. The NFPA 110 crowd — the folks who write the rules for hospital and emergency backup power — expect a set to swallow its full rated load in a single step. If your machine is backing up anything where lives are involved, test exactly that. Not 50%. All of it. At once.
Commissioning day generates the most valuable data the generator will ever produce: its healthy baseline. Every reading you take on a good day is a comparison point for every bad day that follows. And almost nobody writes them down.
So here’s my one list. Copy it onto a clipboard, or into your phone, on commissioning day:
Two years from now, when the set is running hot and nobody knows whether it’s “always been like this,” that scrap of paper is worth more than the factory certificate. I’ve settled more warranty arguments with a commissioning-day notebook than with anything else I own. The numbers don’t have opinions. That’s what makes them useful.
A new diesel engine is not broken in. The first oil and filter change comes much sooner than the normal service interval — usually around 50 hours, though your manual has the final word. That first oil carries the wear metals from everything seating itself in. Leave it in too long and you’re circulating grinding paste.
While you’re at it: verify the coolant concentration with a refractometer, not by eyeballing the color. Check that the battery charger is actually floating the batteries in the right voltage range — high twenty-sixes for a 24-volt system, roughly. Walk the fuel lines once more for weeps at every fitting; new fittings settle. Our fuel system piece covers what bad fuel does to a set — commissioning day is when you confirm the fuel it starts life with is clean and water-free.
And run the automatic transfer switch through a full transfer-and-retransfer cycle while you’re standing there. Not a simulation. Kill the mains, watch the set start, watch the load transfer, restore the mains, watch it transfer back and cool down. If the ATS is going to embarrass you, let it do it while the installer’s phone number still works.
The factory load-banked your set before it shipped — we covered what a proper load bank test proves and doesn’t prove — but a load bank in a test cell is a polite, resistive, well-behaved load. Your site isn’t. Commissioning is the first date between the machine and reality. Be there for it, test the ugly stuff, write down the numbers, and do the early oil change. Do that, and the certificate on the control panel door actually means something. If you’re taking delivery of a set soon and want a second pair of eyes on the commissioning plan, talk to us before the truck arrives — it’s a lot cheaper than after.
