The rain cap clanged when I lifted it. What ran down my glove wasn’t rainwater. Thick, black, smelling of raw diesel — the exhaust stack of a 400 kVA standby set, weeping oil. The building manager stared at my glove like I’d done a magic trick.

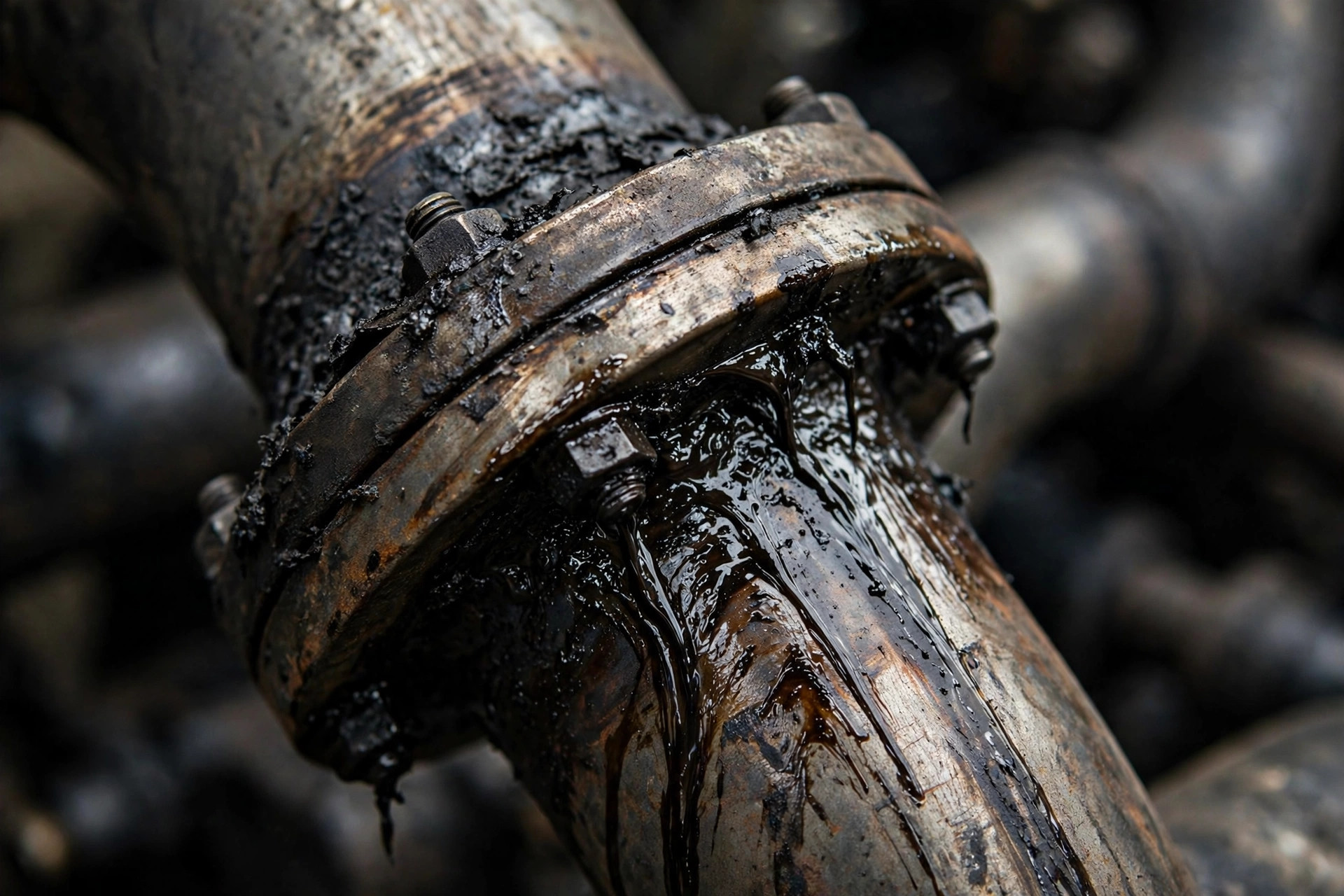

I hadn’t. That black slime has a name. Wet stacking. And if your generator spends its life doing little weekly exercise runs with nothing plugged in, yours is making it too.
A diesel engine is a heat machine. It needs to get properly hot to burn fuel cleanly. Run it at ten or fifteen percent load and the cylinders never reach working temperature. Fuel doesn’t fully burn. Some washes past the rings. Oil mist joins in. All of it ends up caked inside the exhaust as a black, tarry mess.
That’s wet stacking — unburned fuel and oil, stacked up wet in the exhaust system. Do it for years, the way most standby sets live, and the damage goes deeper than the stack.
Modern common-rail engines resist it better than the old mechanical-injection lumps — tighter tolerances, better atomization. “Better” isn’t “immune.” I’ve seen slobber on Tier 4 Final sets that spent their lives on light exercise. Low load is low load, whatever the emissions sticker says.
Here’s the thing. The goo dripping from exhaust joints — techs call it slobber — is only the visible part. Inside, three worse things are happening.
Start with the cylinder walls. They glaze. The bores polish smooth instead of keeping their honed crosshatch, rings stop sealing, oil consumption climbs, compression drops. A glazed engine can look clean on the outside and be tired on the inside.
Then the injectors foul. Carbon builds on the tips, spray patterns go sloppy, combustion gets dirtier. A vicious circle — bad burning makes more deposits, and deposits make burning worse.
And the turbo cakes up. Soot and unburned fuel coat the turbine side, boost drops, and the engine makes less power exactly when you need all of it.
I’ve seen all three in one machine. A hospital standby set, 400 kVA, six years old, that had done nothing but twenty-minute no-load exercises every week since commissioning. When we finally put a load bank on it, the set couldn’t hold seventy percent. The exhaust looked like a chimney fire. The facilities manager went pale. His “perfectly maintained” generator was, mechanically speaking, a worn-out engine with two hundred hours on the clock.
You don’t need instruments. Walk up to any standby generator and check three things:
Want proof? Put a real load on it. A wet-stacked set smokes like a freight train for the first twenty minutes — years of deposits burning off — and the exhaust note changes as the cylinders start sealing again. Honestly, watching that smoke clear is one of the most satisfying sights in this job.
Work it hard. That’s the whole secret.

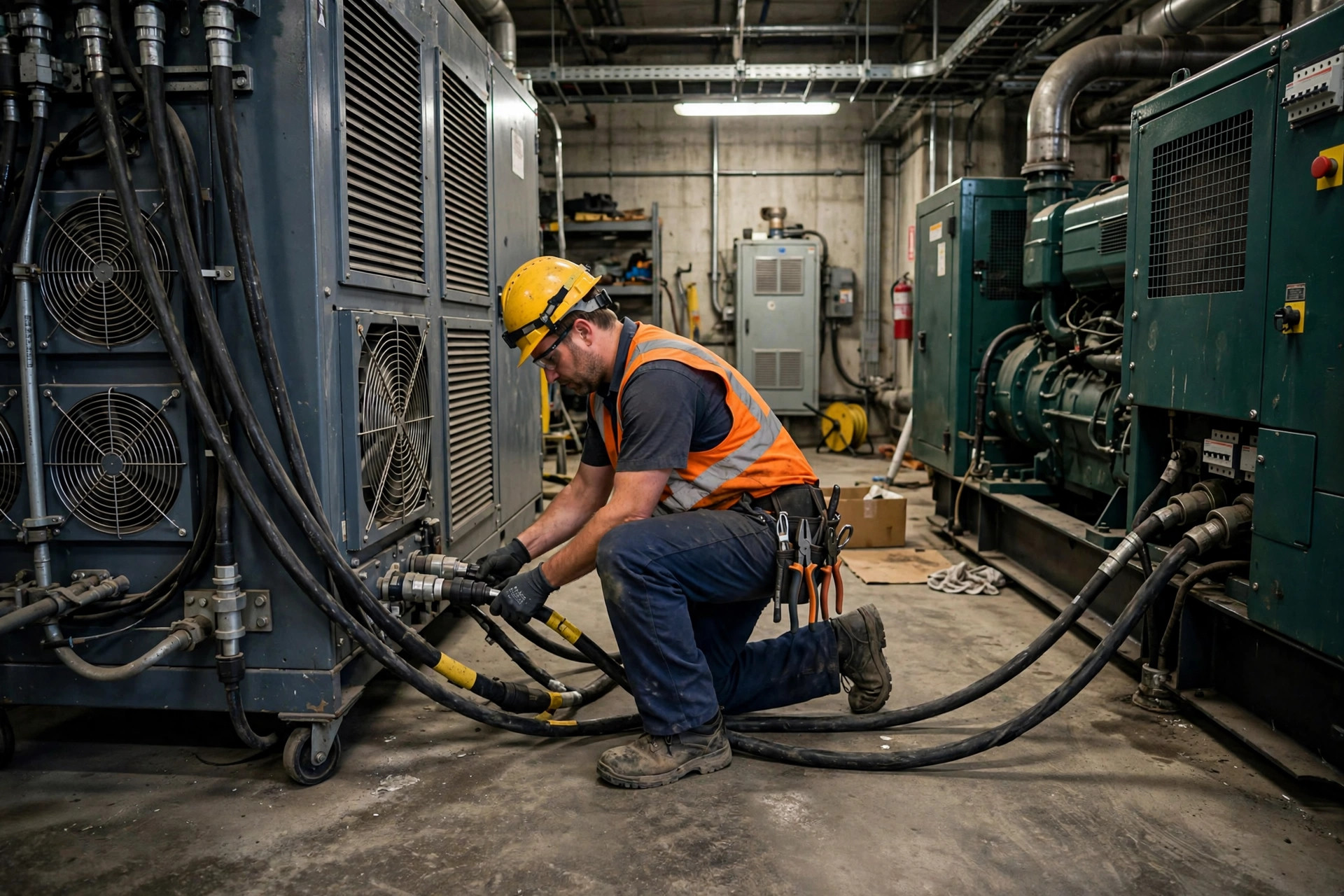

A load bank test — a big resistor box that pretends to be your building — run at seventy to one hundred percent of rated load for an hour or two, burns the deposits out. The stack dries up. Injectors clean themselves. I’ve watched exhaust temperatures climb, the smoke thin out, and a “dying” generator come back to something close to its nameplate.
How often? Once a year at minimum, for any standby set that never sees real load. NFPA 110 — the standard hospitals live under — wants monthly tests at thirty percent of nameplate kilowatts or better, load bank if you can’t get there on building load. Thirty percent. That’s the floor, not the goal.
One honest caveat. A load bank burns off deposits, but it can’t un-glaze a badly glazed bore. If oil consumption stays high after two good loaded runs, the crosshatch is gone and you’re looking at a hone or a rebuild. I’ve had to deliver that news twice. Neither owner thanked me at the time. Both did later — one of them after the rebuilt set held full load through a real outage.
An old-timer I worked with swore weekly no-load runs were “better than nothing.” We argued about it for years. He retired still convinced. I’m convinced he was wrong — a weekly no-load run doesn’t exercise a generator, it keeps the battery charged while the engine slowly glazes itself. I’ve written before about why a green weekly test log proves nothing; this is the mechanical reason underneath. If all you can manage is no-load, do it monthly, not weekly — and load-bank the set once a year. Don’t argue with me on this one. Actually, go ahead. The old-timer did.
Here’s the uncomfortable part. Most wet-stacked generators were doomed the day they were bought.
Somebody sized the set for the whole building, and the building never drew more than a third of it. Or the “growth margin” was fifty percent and the growth never came. A 500 kVA set loafing along at 80 kW is a wet-stacking machine with a warranty card.
I’m not saying buy small — an undersized set is worse, it’ll sag or trip on motor starting current. But a standby generator should expect to see real load. If your actual outage load sits under thirty percent of the nameplate, you bought too much generator, and no maintenance schedule fixes that. Size it right, or budget a yearly load-bank session as the price of your safety margin.
And when someone tells you their generator “runs great, starts every week” — smile, lift the rain cap, check your glove. The stack never lies.
Go look at your own set this week. Rain cap up. Dry inside? You’re fine. Black and sticky? Now you know exactly what to do about it.
